Installation Report
DVIA-P Series
02-08-2023

Vital Optics Technology Raith Voyager EBL DVIA-P2200 Installation Report

DVIA-P Series
Installation Report
Vital Optics Technology
Raith
Voyager EBL
221118R4

Overview

The DVIA-P2200 active vibration isolation platform is appropriately installed and functioning as intended.

Measurement date: 2023.02.08 (Wedday)

Operator: DAEIL SYSTEMS, Hosang Yu

Place of measurement: ANHUI

Equipment Model: Raith Voyager EBL

Equipment Set-up

End User

Vital Optics Technology

Target Equipment

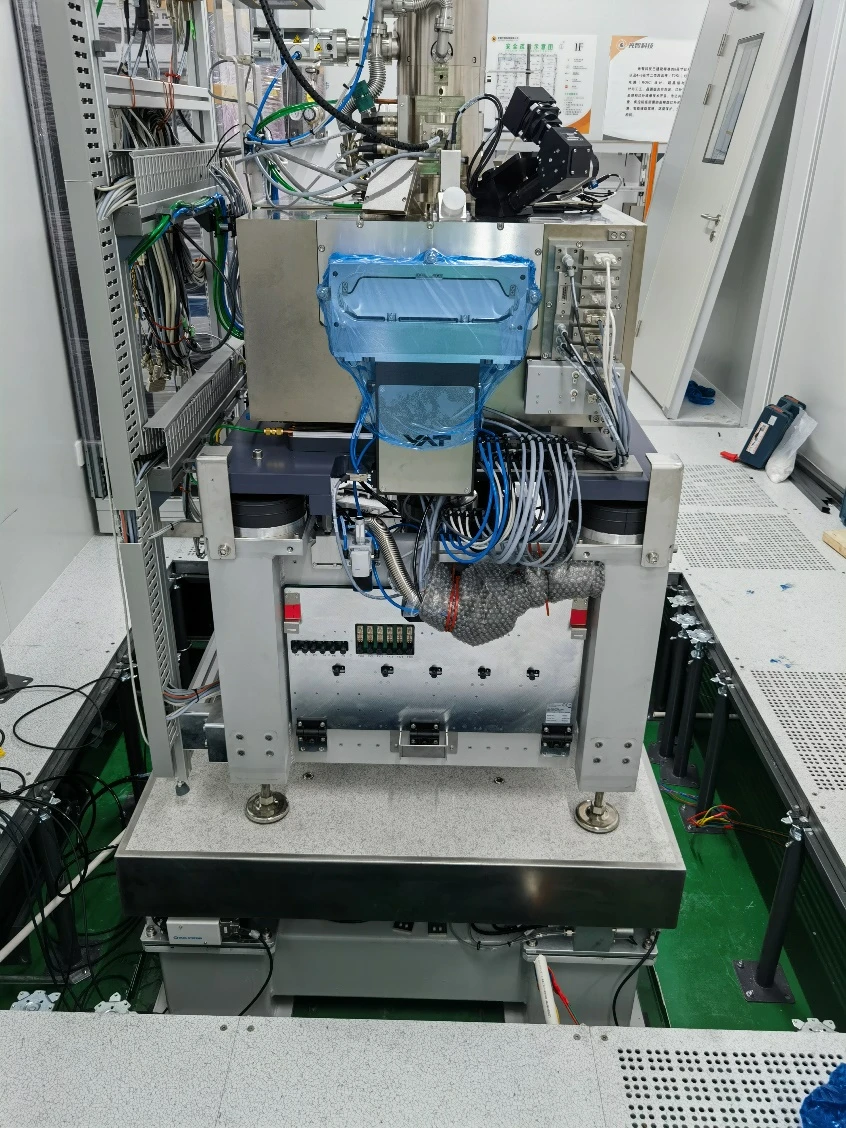

Raith Voyager EBL

Place of Installation

ANHUI

Remark

Good Performance

Operator

Yu, Ho sang

Date of Setup

23.02.08

Date of Reporting

23.02.09

Date of Business Trip

17.12.27~17.12.29

Measurement Date

2023.02.08 (Wedday)

Summary of Measurement Results

Test ConditionVC-ClassZXY
FloorBCC
Above ActiveEEE

Good omnidirectional performance.

MB1000 Internal Program Performance Measurement Result

Z axis

X axis

Y axis

Octave Band Result

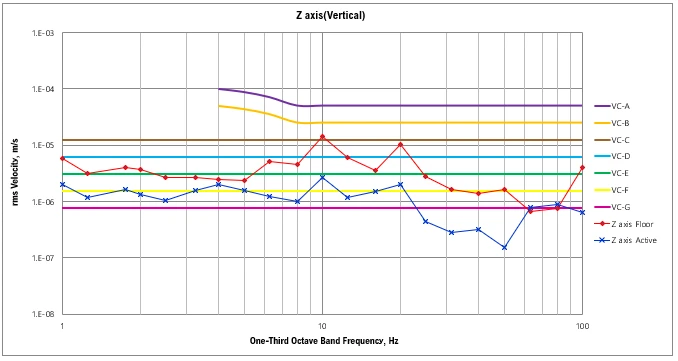

Z axis

X axis

Y axis

Share this Case Study

Case Study Information

Category
Installation Report
SeriesDVIA-P Series
Date02-08-2023
Tags
DVIA-P Series
Installation Report
Vital Optics Technology
Raith
Voyager EBL
221118R4
